Guide

How to Import Windows from Europe to the US: 7 Steps (2026)

Kai Adamek

By Kai Adamek - Independent European window agent - aluminum, wood, aluminum-clad wood, uPVC and real steel systems for projects in the US and Canada

Published Updated 9 min read

Importing windows from Europe to the US is a seven-step procurement job: a request for quote from a window schedule, a system shortlist priced on 2-3 European systems, shop drawings in inches that you sign, a deposit that books the production slot, production and crating, a container to a US port with customs clearance, and delivery to your site. On my orders the budget estimate comes back the same or next working day, shop drawings 2-3 working days after the quote review, and the units arrive 9-16 weeks after approved drawings for uPVC and aluminum, DDP, with freight, customs clearance and duty already in the price.

The hard part of an import is never finding a factory. It is making sure one party owns every step between the drawings and the jobsite, so nothing falls into the gap between the fabricator, the forwarder, the customs broker and your framing crew. This guide is that chain, step by step, with who does what, what each step costs you in time, and where imports go wrong.

Reynaers aluminum windows in protective film, strapped to timber pallets on the factory floor before loading for a US project

What are the steps to import windows from Europe?

The import runs in seven steps, and the table says who owns each one and how long it takes on a project I manage; installation is never my scope. The same pattern applies on any route, but when you buy direct from a fabricator every "Me" row becomes yours.

Step What happens Who owns it Time
1. Request for quote You send a window schedule or plan and elevation PDFs with sizes, opening types, glazing and the jobsite location You, with your architect; I take off the openings Budget estimate the same or next working day
2. System shortlist and DDP quote The schedule is priced on 2-3 European systems that fit the openings; the quote is line-item and DDP Me, with a written scope of supply With the estimate review
3. Shop drawings Every position drawn in inches: dimensions, handing, glass, finish, attachment, screens Me with the fabricator; signed off by you or your architect 2-3 working days after the quote review, plus your review time
4. Order and deposit The order is confirmed on the signed drawings and the deposit on the proforma invoice books the production slot You pay; I schedule production on receipt Production is scheduled from the deposit, the lead time runs from approved drawings
5. Production, glazing and crating Profiles cut and assembled, glass set, hardware fitted, units wrapped, corner-protected and strapped to pallets or A-frames The European fabricator, on the approved drawings Inside the 9-16 weeks
6. Container, customs and duty One 40 ft container carries roughly 2,500 sq ft of units; smaller orders ship less-than-container below about 250 sq ft; the entry is filed and duty paid Me, inside the DDP quote; a licensed customs broker files the entry Inside the 9-16 weeks, by coast
7. Delivery, unloading and installation The container or truck arrives at the site; your crew unloads, stores and installs, briefed on the system before the crates arrive Your local team; I brief them Local schedule

The container figures are the planning assumptions of my estimator: a 40 ft container for about 2,500 sq ft of units, and a less-than-container minimum below about 250 sq ft, which is why a two-window order carries a far higher freight share than a whole-house package. For a project in Canada the same steps apply with one change at step 6: the order ships DAP, the Canadian buyer is the importer of record, and the EU-origin units enter duty-free under CETA with an origin declaration I prepare; see importing European windows to Canada.

Which European window system should you import?

Import the system that fits the openings, the energy target and the material brief, not the brand you have heard of; on one schedule I usually price 2-3 of them side by side. European system providers are not interchangeable: some platforms are strong on passive-house-grade tilt-and-turn, others on large lift-and-slide doors, slim steel-look grids or aluminum-clad wood.

The decision starts with the material. Thermally broken aluminum from Reynaers, Aluprof, Aliplast or Cortizo gives the slimmest sightlines and the largest sashes, up to 9 ft 2 in (2,800 mm) high and 441 lbs (200 kg) on Reynaers MasterLine 8, with whole-window U-factors down to 0.11 on Aluprof MB-86 AERO. uPVC on Aluplast Ideal Neo reaches 0.13 triple glazed at the lowest cost per unit. Wood and aluminum-clad wood on the Timber and Clad lines are quoted from drawings, and real steel on Jansen Janisol is a separate quote. The European windows guide compares the materials with the numbers, and the aluminum vs PVC guide settles the most common choice. If you are looking at Polish fabricators specifically - I am based in Wroclaw - windows from Poland covers what changes on that route.

The right questions for any system are operational: can it be built to the exact configuration, does the configuration carry the documentation your permit needs, can the fabricator issue clean shop drawings in inches, and does the lead time fit the framing schedule. My supplier evaluation checklist is the full list.

What documentation does a US permit need on imported windows?

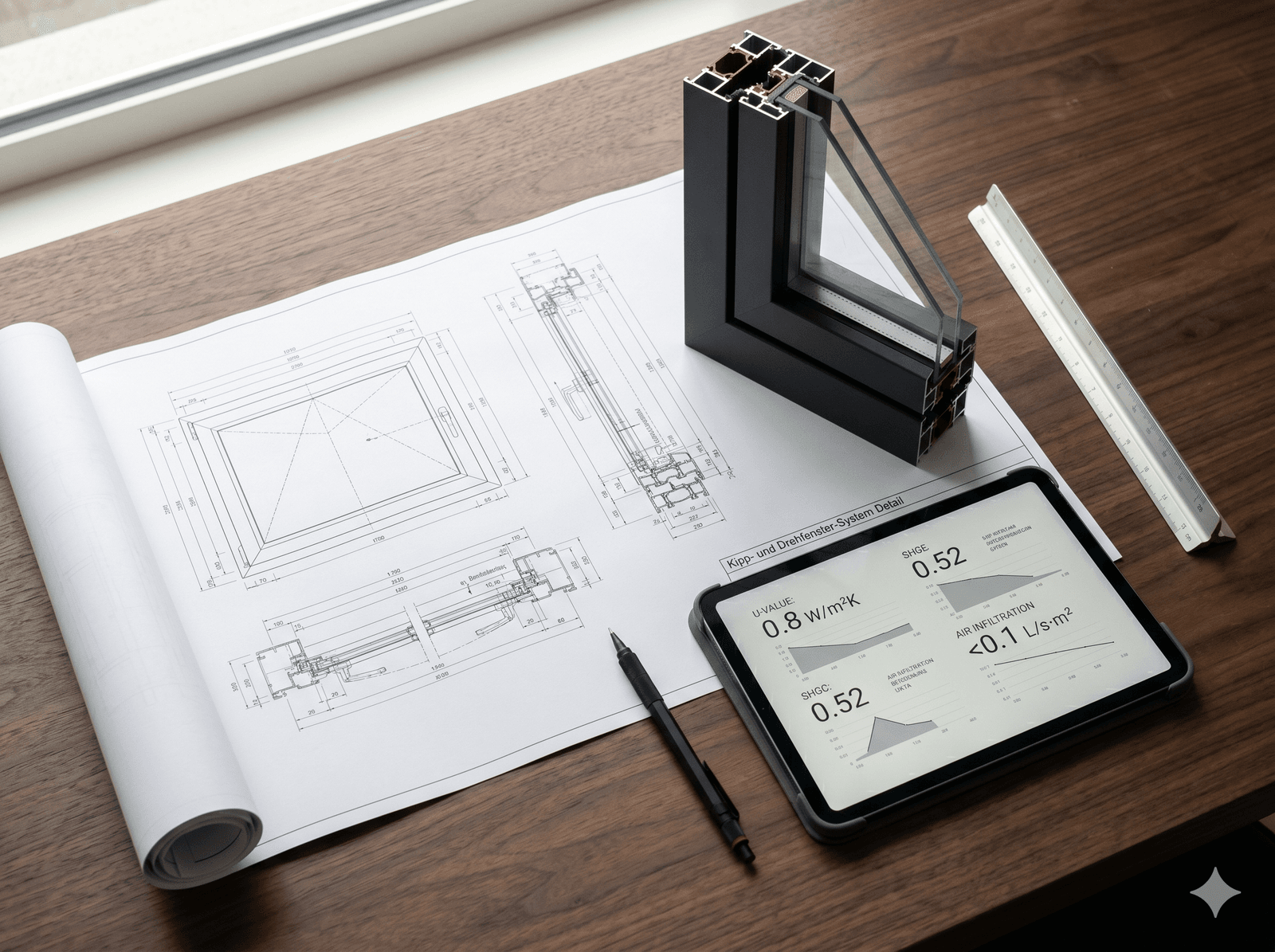

A US plan reviewer may ask for NFRC U-factor and SHGC values and, for structural performance, NAFS data on the exact configuration; CE marking under EN 14351-1 does not substitute for either. Some configurations carry the US documentation and many do not by default, so the question belongs at step 2, before the order, not at the permit counter.

European data sheets quote Uw in W/m2K, which converts to the US U-factor at 0.176; the Uw converter does the arithmetic, and the converted value is a metric whole-window figure, not an NFRC label. Where the permit needs the label, I confirm which system and configuration carries one; the estimator prices an NFRC-labelled configuration as an option where the system has one. California adds Title 24, covered in European windows in California; the IECC targets by state are on the European windows in the USA hub. The detailed pathway, what reviewers ask for and what gets rejected, is in NFRC and NAFS on European windows. The reason direct factory buying goes wrong here is not product quality but translation: a factory knows its product, and it does not always know how a US building department wants the information organized.

What does a landed price for imported windows include?

A landed price covers eleven things the factory invoice does not: packing and crating, inland transport to the European port, export documentation, ocean freight, marine insurance, US customs entry and broker fees, duty, port and terminal handling, final-mile trucking, unloading equipment where the site needs it, and a contingency for schedule movement. The factory price is one line in that budget, and a quote that stops there is not a price you can bid.

The two numbers that move most are freight and duty. Freight is allocated across the shipment, so the container assumptions above decide whether a small order is viable on its own or should ride with a larger one. Duty depends on the product, its origin, the shipment and the entry date; the HTS classification of the actual product decides the treatment, confirmed with the customs broker, which is why I do not put a rate in a blog post and why every US quote I send is DDP with a validity period. Background on duty exposure is in European window import costs, the supplied price list by size is in the European windows price list, and the estimator shows the supplied and the landed number side by side for your schedule. The question is never who is cheapest at the factory gate; it is who gave the clearest landed project price.

A 40 ft Maersk container on a truck at the European loading yard before the ocean leg to a US port

Who handles customs on imported European windows?

Under DDP (delivered duty paid) the seller's side files the entry and pays the duty; under DAP (delivered at place) the buyer does, as importer of record, with their own customs broker. Every US quote I send on aluminum, uPVC, wood and aluminum-clad wood is DDP; real steel delivery terms are confirmed per project.

The difference is who carries the risk between the port and your site. Under DAP you need a customs broker, a continuous bond or a single-entry bond, an HTS classification for each product, and someone on your side to answer the broker's questions while the container sits at the terminal. Under DDP that is my scope, and the number on the quote is the number at the site. The full mechanics are in what DDP means on a window import. Canadian orders are the exception by design: they ship DAP because the Canadian buyer is the importer of record for GST purposes, and the CETA origin declaration I prepare is what makes the EU-origin units duty-free at the border.

What goes wrong on window imports, and how do you prevent it?

Six mistakes cause most import problems, and every one of them is preventable before the order is placed. The table pairs each with the fix.

Mistake What it costs Prevention
Ordering before the schedule and elevations are stable Revisions after drawing sign-off restart the production queue Freeze the schedule at frame stage, then approve drawings once
Comparing non-equivalent quotes A factory price without freight looks cheaper than a DDP price with it Compare landed, like-for-like scope: glazing, screens, fins, finish, freight, duty
Assuming CE marking satisfies the permit A rejected submittal and a configuration change after production Settle NFRC and NAFS documentation at the quote stage
Slow shop-drawing approval Each week of review is a week of production and a lost freight slot Treat drawing sign-off as a construction milestone with a date
Treating installation as an afterthought Bracket-mounted units installed as if they had a nailing fin Brief the crew on the system; read the bracket-mounted installation guide
Ordering too late Windows on site after the trim-out date Place the order 9-16 weeks plus your drawing-review time before the install date

The schedule risk is the one that hurts most, because it compounds: a two-week delay in approvals is a two-week delay in production, and the container booking moves with it. The three phases of a window order break the 9-16 weeks down so you can see where the time goes.

How do you install imported European windows?

Your local crew installs them, with the one difference that most European systems are bracket- or screw-fixed into the rough opening rather than nailed through a fin, so the crew needs the system's installation drawing and a short brief before the crates arrive. A nailing fin is available on selected systems, including Ideal Neo OUT in uPVC and Clad Hidden Sash in aluminum-clad wood, where the schedule calls for US practice.

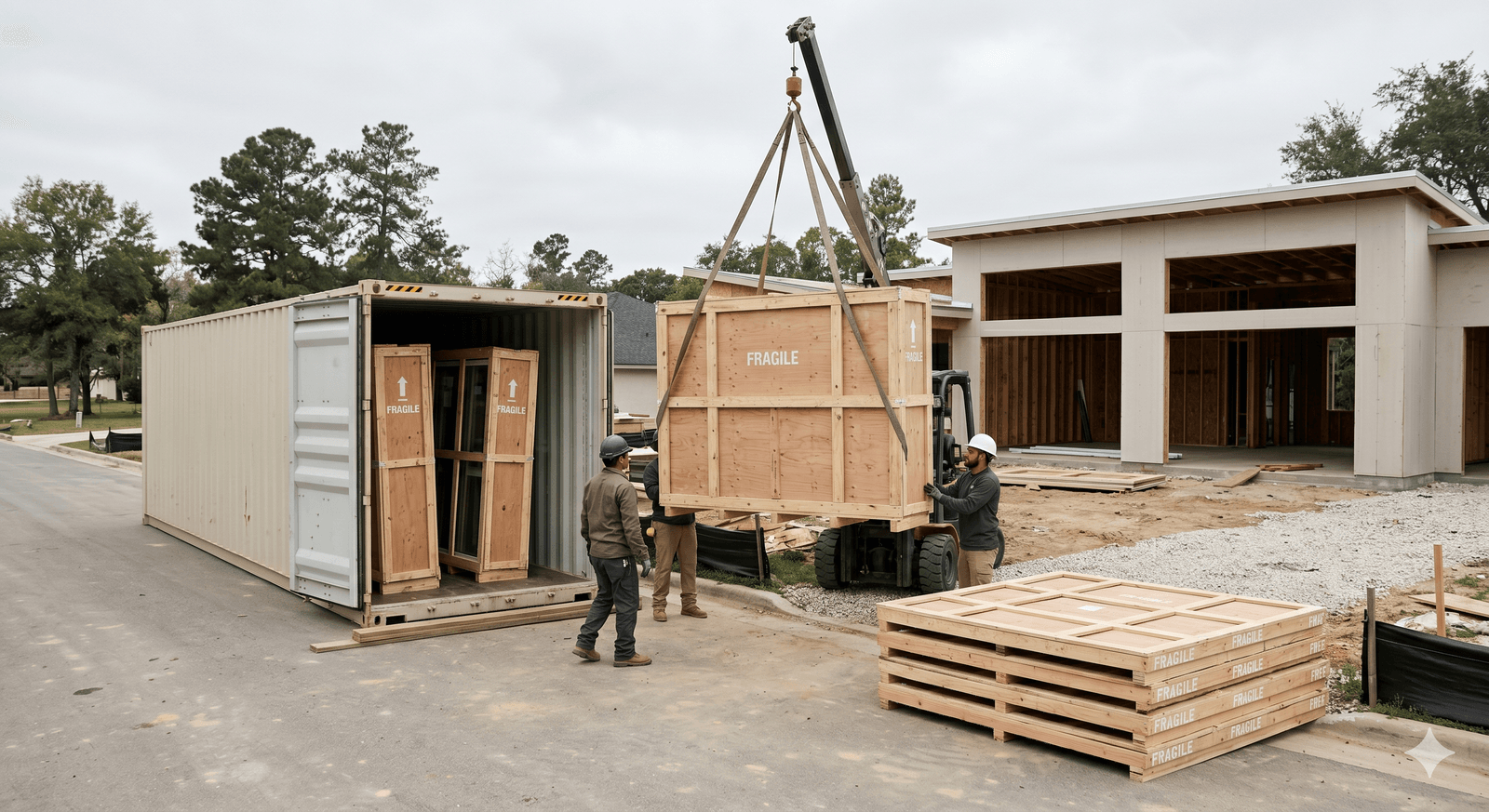

A black aluminum window frame wrapped for transport, standing in front of the container before loading

Rough-opening tolerances are tighter than standard US framing because the unit is built to the opening, so the shop drawings carry the clearances and the installer works to them. Flashing, sill pans and air sealing follow the same logic as any high-performance window. The systems are not difficult to install; they are different, and the differences matter for the written warranty, which Windows Guy sp. z o.o. issues for 10 years on aluminum, uPVC, wood and aluminum-clad wood, with steel terms confirmed per project.

FAQ

How do I import windows from Europe to the US? Send a window schedule, get a budget estimate the same or next working day, compare 2-3 European systems priced on that schedule, sign shop drawings in inches, pay the deposit that books production, and plan on 9-16 weeks from approved drawings to a DDP delivery at your site for uPVC and aluminum. Your local crew installs. On my orders one party, me, owns every step between the drawings and the site.

Do European windows automatically meet US code if they have CE marking? No. CE marking confirms compliance with EN 14351-1 for the EU market. A US plan reviewer may ask for NFRC U-factor and SHGC values and NAFS structural data on the exact configuration. Some configurations carry both, many do not by default, so confirm the documentation at the quote stage.

What is a realistic lead time for imported European windows? Plan for 9-16 weeks from approved shop drawings to site delivery for uPVC and aluminum, depending on material and coast; wood, aluminum-clad wood and custom colors are scheduled and confirmed per order. The clock starts at drawing approval, not at the quote.

Are duties always charged on European windows? Duty depends on the product, its origin, the shipment and the entry date, and the HTS classification of the actual product decides the treatment. I do not quote a rate in a post; every US quote I send is DDP with a validity period, so the duty is inside the number. Canadian orders enter duty-free under CETA with an origin declaration.

Who handles customs clearance on an imported window order? Under DDP the seller's side, which is me on my US orders: a licensed customs broker files the entry and the duty is paid inside the quote. Under DAP the buyer is the importer of record and uses their own broker; that is how Canadian orders ship, with the CETA origin declaration from my side.

Can I install European windows with a regular US framing crew? Yes, with the system's installation drawing and a short brief. Most European systems are bracket- or screw-fixed rather than nailed through a fin, the rough-opening clearances are on the shop drawings, and flashing and air sealing follow normal high-performance practice. A nailing fin is available on selected systems.


Next step: send me your window schedule with sizes, opening types and the jobsite location, and I come back with a system shortlist and a DDP budget range the same or next working day; or run it through the estimator first for a quick supplied-and-landed range.

What would your project cost?

Use your opening sizes for an indicative budget, or send your schedule for a personal review of suitable systems and delivery scope.
